Nscale’s Monarch Compute Campus in Mason County, West Virginia, has a signed Anthropic customer agreement and documented civil construction. For subcontractors, the useful starting point is Nscale’s project inquiry and its named participating employers. For tradespeople, a workforce agreement with two building-trades councils provides a referral route.[37][8][32]
The campus is north of Point Pleasant. Nscale’s campus page checked November 11 gives 1.38 GW of phase-one AI computing capacity. The overview no longer includes the early-2028 delivery target recorded November 10 and provides no replacement delivery date.[1] September reporting described roughly 900 workers across the site and related pipeline work.[8] The companies, applications and referral contacts below help readers pursue participation; available packages and current craft demand require confirmation.
Subcontractors: identify the buyer for your scope. Tradespeople: start with craft referrals and apprenticeships. The two retained Nscale job descriptions concern senior management, not craft vacancies.
Monarch phase one at a glance
| Question | Answer |
|---|---|
| Where is the site? | Mason County, north of Point Pleasant. The proposed power facility is at 30 Monarch Way, off Ohio River Road near the former Mason County Airport.[8][35] |
| Who is developing it? | Nscale, which acquired American Intelligence & Power Corporation on March 31, 2026. Monarch Cloud Campus LLC is the environmental permit applicant.[37][35] |
| What is phase one? | Nscale’s November 11 page gives 1.38 GW in both the overview and facts panel. Its overview no longer includes the previously advertised early-2028 delivery target; no replacement date is stated. The air application describes three H-shaped data-center buildings.[1][34] |
| Who is the customer? | Anthropic signed four GPU-service agreements on August 25. Payments could total up to about $44.6 billion, subject to delivery and service conditions.[37] |
| What activity is documented? | September 20 reporting described civil work and preparations for vertical construction. That account does not establish today’s building-by-building completion.[8] |
| What does it cost? | Nscale’s November 3 page advertises more than $69 billion in planned capital investment; the October 21 page said more than $20 billion. A commissioned EY model uses $69.2 billion in phase-one development spending, including equipment. Neither figure is an open construction budget.[1][36] |
| How can a contractor inquire? | Use the inquiry on Nscale’s Monarch page and ask for the buyer responsible for your scope. No project-specific open bid package was verified in this review.[1] |
| Where can workers start? | Experienced workers can ask the building-trades councils about craft referrals. New entrants can contact apprenticeship programs. Two Nscale management descriptions were retained from the October 21 application check.[32][28][29] |
The power-facility address is a regulatory location, not a verified worker entrance or delivery gate. Get reporting instructions from the employer before traveling.
Anthropic, Microsoft and project financing
Nscale’s September 18 registration statement documents four Anthropic agreements signed August 25 for GPU infrastructure at Monarch.[37] The agreements provide for payments up to approximately $44.6 billion, with services deployed in four tranches.[37] A tranche is a separately delivered portion of the computing service. Payments depend on delivery and availability requirements; the headline value is not money already received.[37]
The filing says Nscale had no binding commitments for the financing required to perform those agreements as of the prospectus date.[37] Missed delivery deadlines or sustained service failures can give Anthropic termination rights.[37] Those conditions matter to suppliers assessing the timing and credit exposure of a large equipment or construction order.
Nscale subsequently announced a $3.36 billion company-wide convertible-note financing on September 25.[40] It described an initial $2.36 billion tranche at closing and a further $1 billion NVIDIA commitment expected in mid-November.[40] The announcement does not identify that transaction as completed financing for the Anthropic obligations.[40] The September filing establishes the financing gap at that date, not proof that it remains unchanged today.[37][40]
Microsoft’s March Monarch announcement was a letter of intent.[2] Quartz reported October 20, citing Bloomberg, that Microsoft withdrew from the West Virginia site over the summer, allowing Anthropic to take its place.[38] That reported change concerns Monarch, not every Microsoft contract across Nscale’s business.
Bloomberg’s October 19 report describes negotiations for a second Monarch facility in a deal that could be worth about $45 billion.[39] Quartz describes the proposed building as another 460 MW, with terms still unsettled.[38] DCD reported on November 2 that a second agreement had been signed in October, but linked back to its earlier talks report. No second executed agreement was recovered for this update.[47]
DCD’s November 2 report, citing The Information, describes NVIDIA negotiations for more than $5 billion in credit support for power and construction at the first Anthropic building.[47] The reported guarantee would help Nscale borrow for the buildout; it remains a financing negotiation, not confirmed funding or an available construction package.
Contractors: named companies and the buying route
Nscale’s June job-fair announcement names employers working with it, including Ames Construction, Apex, Boyd CAT, ERM, Kiewit, Rettew and Thrasher.[4] It identifies useful organizations to research, but does not assign their construction packages or name a campus-wide general contractor.
| Organization | Documented involvement | Before approaching for work |
|---|---|---|
| Nscale | Developer and intended operator. Its construction leadership role includes selecting and managing construction firms and major subcontractors.[1][29] | Ask which purchasing team controls your scope and phase. |
| Ames Construction, Apex, Boyd CAT, Kiewit, Rettew and Thrasher | Named employers working with Nscale in its June job-fair announcement.[4] | Confirm the firm’s package and whether it buys the service you sell. |
| Environmental Resources Management (ERM) | Named in the job-fair announcement and submitted the reviewed state-waters applications for Monarch Cloud Campus LLC.[4][26][27] | Environmental application work does not establish a broader construction contract. |
| Caterpillar and NVIDIA | Named power and computing collaborators. The air application specifies Caterpillar gas engines.[2][34] | Equipment involvement does not identify the installing contractor or an open local purchase order. |
| WV and Tri-State building-trades councils | Signed a workforce agreement with Nscale covering the data center and power facility.[32] | Ask about the appropriate craft and referral process. |

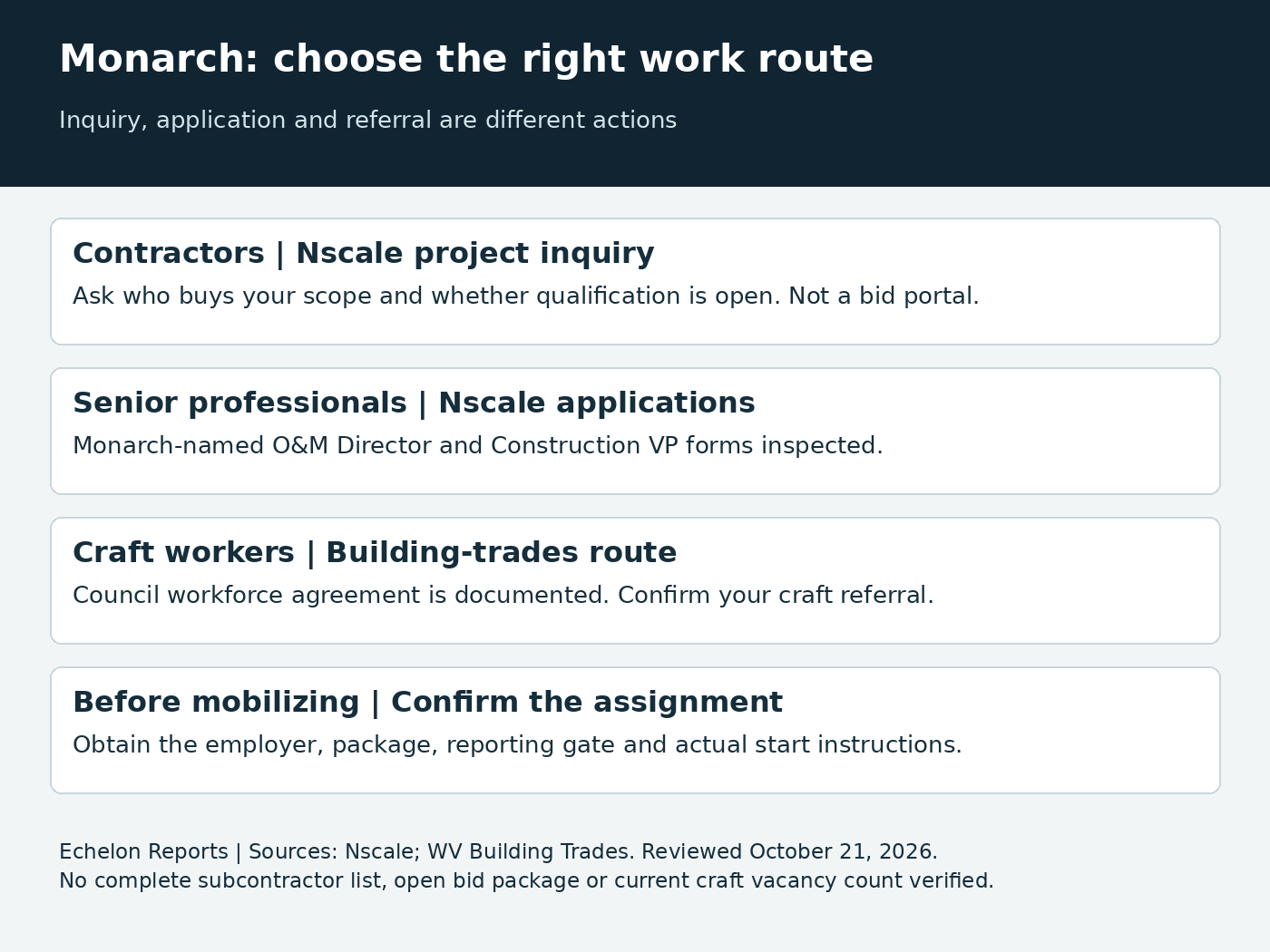

Start with Nscale’s Monarch project inquiry. Its form accepts company and contact details with a message.[1] Explain your trade, relevant project experience and available workforce. Ask for the buying entity, package owner, qualification requirements and submission method. An actual bid invitation should identify the scope and deadline before you commit estimating time.
Workers: craft referrals, training and applications
Experienced tradespeople
The West Virginia Building & Construction Trades Council and Tri-State council have a documented workforce agreement with Nscale for Monarch.[32] Ask which affiliated local handles your craft and whether an employer has requested workers for this project. Their published contacts are:
- WV Building & Construction Trades Council: 304-346-1367.[41]
- Tri-State Building & Construction Trades Council: 606-324-9880.[42]
The agreement provides a workforce route, not a current dispatch order. Ask about referral eligibility, the employer, worksite, start date and required credentials. Obtain wage, overtime, travel and lodging terms from the employer or hiring hall before accepting an assignment.
Ames Construction’s craft-teams page provides an employer-wide job search.[45] Search by trade and location, then ask the employer whether the assignment is at Monarch. No Monarch-named craft listing was verified in the October 21 employer review.
Apprenticeships for new entrants
Plumbers & Fitters Local 521 lists Mason County among its eligible applicant counties and publishes 304-523-6085 for its training coordinator.[43] Applications open at announced times.[43] The program says its selection list is for future requirements and is not an employment offer.[43]
Iron Workers Local 787 also lists Mason County within its jurisdiction and publishes 304-485-6231 for its apprenticeship coordinator.[44] Confirm current intake and eligibility before visiting. These are local training routes, not verified Monarch placements.
Nscale management positions
The two senior management descriptions below named Monarch and displayed application sections on October 21, 2026.[28][29] These are dated employer leads; check the linked listing for current availability.
| Listing | Location and advertised requirements |
|---|---|
| Director of Operations & Maintenance, ID 4871255101 | On-site in Mason County; at least 15 years of relevant operations leadership. Advertised base salary: $160,000 to $210,000.[28] |
| Construction, VP, ID 5005104101 | Monarch Project Site; leadership of field execution across power and data-center infrastructure. Advertised base salary: $230,000 to $410,000.[29] |
Nscale’s Monarch page also accepts questions about skilled-trades opportunities.[1] Use that route for a project question; submit an application through the named employer’s listing. Availability can change after the review date.

Phase-one compute and the power plant

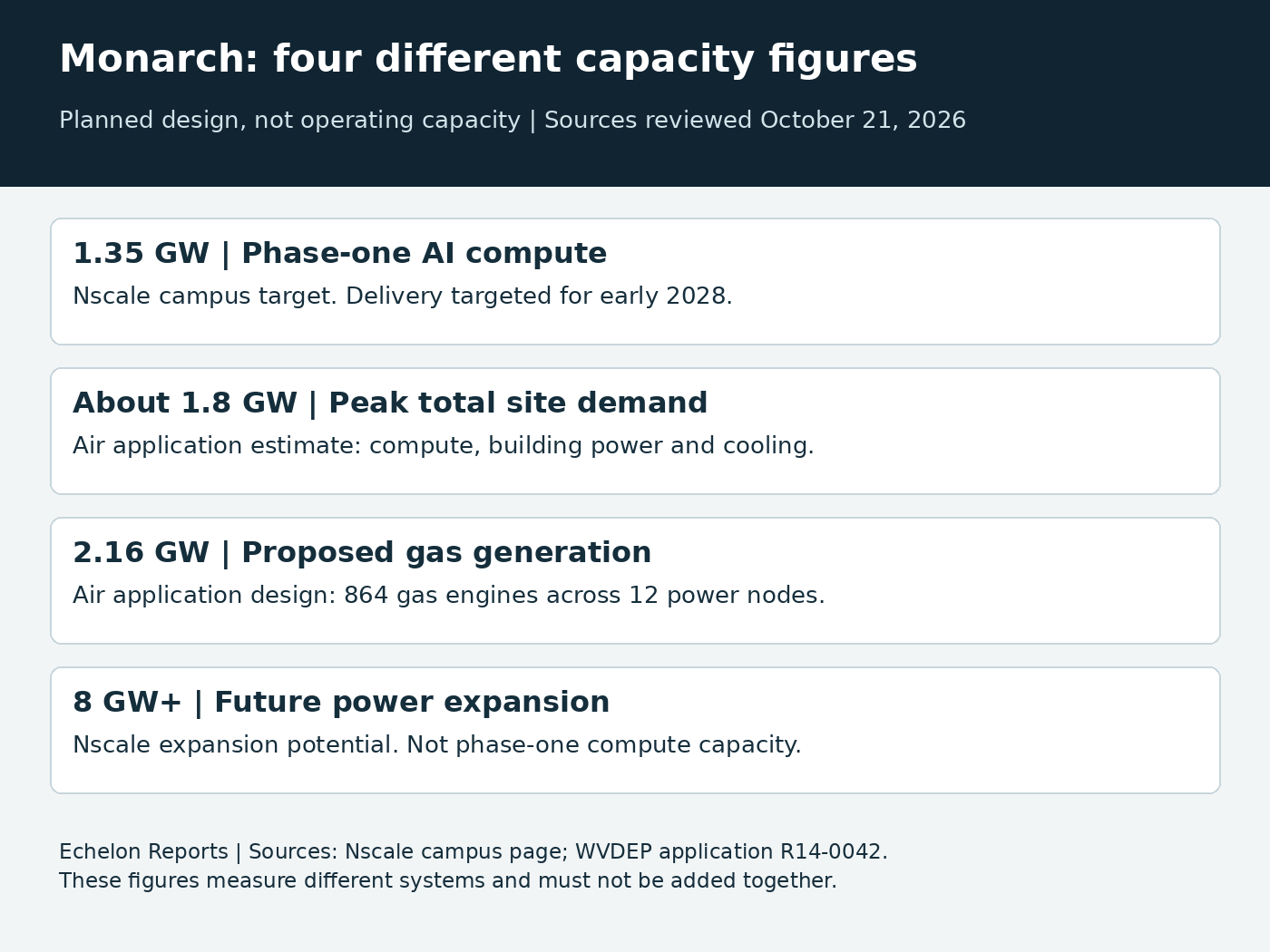

Nscale’s campus page gives 1.38 GW of phase-one AI computing capacity in both its overview and facts panel, checked November 11. This resolves the difference recorded in the November 3 observation.[1] The air application describes a different measure, 1.8 GW of peak total site demand, including computing, buildings and cooling. It proposes 2.16 GW of natural-gas generation from 864 engines across 12 power nodes.[34]
The September SEC filing targets 2 GW of gross generation and 1.37 GW of IT load by the first half of 2028.[37] The owner page, filing and permit design have not reconciled these figures. Use the equipment and load specifications in the actual package documents when pricing work. The graphic retains the earlier 1.35 GW owner description alongside the permit figures.
Nscale advertises 8 GW-plus of future power potential and on-site generation.[1] Its water facts panel now limits its no-drinking-water claim to evaporative cooling, although another paragraph on the same page still says no municipal drinking water for operations.[1] The air application describes minimal makeup water.[34] Total operating water use remains unverified; the narrower cooling claim should not be read as zero water consumption.

Construction progress, permits and opening dates
MetroNews reported September 20 that site manager Jason Bechtle described continuing civil work and preparations for vertical construction.[8] His roughly 900-worker estimate covered the site and related pipeline work during the preceding week, rather than a current building-by-building headcount.[8]
WVDEP’s stormwater notice describes failed controls following July 11 rainfall and requires repairs and added erosion protection.[33] The order stopped land-disturbing work in a separate drainage area until controls were installed and the agency verified compliance, rather than describing a campus-wide shutdown.[33] This review did not establish whether that area later received clearance.
WVDEP’s application register still listed R14-0042, facility 053-00136, with a draft permit on November 3. Its last-day-to-comment field says November 13, 2026.[46] The linked public notice instead gives 5 p.m. October 30 and an October 29 virtual hearing.[35] Those official dates conflict. Confirm the applicable deadline with DAQ before relying on either; the checked register did not supply a final Monarch permit.
State-waters applications SWP-26-0002 and SWP-26-0003 cover data centers No. 2 and No. 3. Each describes one building with four power nodes and proposed disturbance limits of about 193 and 166 acres respectively.[26][27] The retained WVDEP notice listed an October 26 comment deadline.[24] These application areas are separate from the owner’s current 2,250-acre campus description; its October 21 page described more than 2,250 acres.[1]
When will phase one open?
Nscale’s campus overview checked November 11 no longer includes its previously advertised early-2028 delivery target. The page provides no replacement date. This wording change does not establish a construction delay.[1] Its September filing targets initial power and IT capacity by the first half of 2028.[37] Earlier milestones remain in other documents: the air notice anticipates facility startup in April 2027, and the operations listing mentions initial operation in early 2027.[35][28]
Those dates may refer to different equipment, buildings or service milestones, but the sources do not reconcile them. Contractors should obtain the schedule for their package. Workers should rely on an employer’s confirmed start instructions, not the campus opening forecast.
Investment and workforce forecasts
Nscale’s November 3 campus page advertises more than $69 billion in planned capital investment, replacing the more-than-$20-billion figure recorded on October 21.[1] EY’s August study, commissioned by Nscale, models $69.2 billion in phase-one development spending, including GPUs and other equipment, using a 1.35 GW data-center and 2 GW power-plant framework.[36] Planned development spending is not the value of unawarded construction packages.
EY models 4,375 average annual direct construction jobs over roughly two years and 645 on-site operating jobs.[36] Its statewide totals reach 9,400 average annual construction-period jobs and 4,220 operating-period jobs after including suppliers and household spending. Nscale’s current website advertises more than 9,400 construction-period jobs each year statewide and 4,220 permanent jobs statewide.[36][1] EY used Nscale’s unaudited management data. Its construction totals count one-year jobs, so one person working for two years contributes two job-years, not two distinct workers.[36]
Questions about Monarch phase one
Where is Monarch Compute Campus?
Monarch is in Mason County, north of Point Pleasant, West Virginia.[8] The proposed power facility is at 30 Monarch Way, off Ohio River Road near the former Mason County Airport. Confirm the actual reporting gate with your employer; this regulatory address is not a verified worker entrance.[8][35]
Is Anthropic or Microsoft the customer at Monarch?
Nscale’s September SEC filing documents four Anthropic agreements signed August 25 for Monarch services, with payments up to about $44.6 billion subject to delivery and availability conditions.[37] Microsoft’s earlier announcement was a letter of intent.[2] Quartz, citing Bloomberg, reported that Microsoft withdrew from the site over the summer.[2][38]
Who is the Monarch general contractor?
Nscale names Ames Construction, Apex, Boyd CAT, ERM, Kiewit, Rettew and Thrasher among participating employers in its June job-fair announcement.[4] That announcement does not identify a campus-wide general contractor or allocate construction packages. Ask Nscale which company controls the work your firm wants to pursue.
How can tradespeople find work at Monarch?
Ask the WV Building & Construction Trades Council or Tri-State council which affiliated local handles your craft and whether a Monarch employer has requested workers.[32][41][42] Use a named employer’s listing for an application. The two Nscale applications in this report are senior management jobs; apprenticeship contacts are training routes, not confirmed campus placements.[28][29][43]
Is phase one an 8 GW data center?
Nscale advertises more than 8 GW of future power potential. Its campus page checked November 11 gives 1.38 GW of phase-one AI computing capacity in both the overview and facts panel.[1] The air application separately proposes 2.16 GW of gas generation.[34] Future expansion, computing demand and generation capacity are different measures.
Has Monarch received its final air permit?
The WVDEP register checked November 3 lists the Monarch construction application R14-0042 and draft permit, without a linked final Monarch permit.[46] Its November 13 comment date conflicts with October 30 in the linked public notice.[35] Confirm the deadline and final decision directly with DAQ before using either for a contracting decision.
Follow the project and compare other campuses
Use the Echelon project finder to compare documented builders, contractor inquiries and worker routes across the data-center reports. It also provides separate contractor and worker email-update requests. A sent request and confirmation are required to subscribe.
Sources and methodology
Page updated November 12, 2026. The November 11 owner-page change, rechecked November 12, resolves the compute-capacity discrepancy and removes the previously stated delivery target. Earlier reporting retains its observation dates. Editorial revision November 3, 2026. Nscale’s campus page, the air-application register and its linked notice were checked November 3; EY’s August study was reread to reconcile investment and statewide employment forecasts. The November 2 DCD financing report was checked against its linked October talks report; the underlying Information article requires subscription access. The remaining reporting, filings, employer listings and trade contacts retain their stated October 21 or earlier observations. Sources include company disclosures, government documents and dated reporting. No bid, application or inquiry was submitted.
- Monarch Compute Campus West Virginia | AI Infrastructure Development
- Nscale and Microsoft Announce Collaboration with NVIDIA and Caterpillar to Deliver 1.35GW of NVIDIA Vera Rubin NVL72 GPUs at Flagship AI Factory Campus in West Virginia | Nscale
- Nscale to Host Monarch Compute Campus Job Fair Connecting Job Seekers with Careers and Training | Nscale
- Monarch Compute Campus to go vertical soon
- Settlements, Orders, or Draft Permits Out to Public Notice
- DRAFT_DEP Cover_Monarch Phase 2 NWP39_20260505.docx
- DRAFT_DEP Cover_MCC DC3_20260506.docx
- Director of Operations & Maintenance
- Construction, VP
- WV Building Trades Sign MOU for Monarch Compute Campus Data Center
- WVDEP Issues Enforcement Order Following Stormwater Violations at Monarch Cloud Campus Construction Site
- Monarch air permit application R14-0042
- WVDEP notice of intent to issue R14-0042
- EY economic and tax contributions of Monarch Compute Campus, August 2026
- S-1
- Nscale in talks with Anthropic for second $45 billion computing deal
- Nscale, Anthropic in Talks for $45 Billion Cloud Computing Deal
- Nscale Raises $3.36 Billion in Pre-IPO Convertible Financing | Nscale
- Contact – WV Building & Construction Trades
- Contact – Tri-State Building & Construction Trades Council
- Plumbers & Fitters 521 : Huntington – WV Building & Construction Trades
- Iron Workers 787 : Parkersburg – WV Building & Construction Trades
- Craft Teams | AmesConstruction.com
- WVDEP air-permit application register, checked November 3, 2026
- DCD: NVIDIA credit-support negotiations, November 2, 2026
