Project Camellia, Georgia: construction status, contractors and job routes

Project Camellia is OpenAI’s proposed data-center campus near Rincon in Effingham County, Georgia.[2][3] Its regional filing describes four buildings totaling 4.4 million square feet and estimates a $20 billion value at full build-out.[2][3][4] Contractors and workers can register interest, but the official project pages reviewed on October 29 do not identify an open construction package or a confirmed craft vacancy.[13][14]

At the October 29 review, the next scheduled county decision concerned the campus itself.[27] Effingham County’s tentative November 3 agenda listed Octans GA LLC’s Camellia site-plan application, as well as a separate zoning-ordinance second reading.[27] The federal notice set a November 4 deadline for comments on the proposed wetland work.[24] Neither date is a construction-start notice.[24][27]

Contractors and suppliers: use the official supplier-interest route, then ask who will purchase your scope. Workers: use the Future Talent Network for future interest, not as a substitute for an employer’s job offer. Both routes are described below.[13][14]

Project facts at a glance

Question Supported answer
Where is the campus? Savannah Gateway Industrial Hub, near Rincon. The federal notice places its review area beside Gateway and Effingham parkways, east of Hodgeville Road and west of Georgia Highway 21.[24]
Who is developing it? OpenAI leads design and development. Georgia DRI 4801 names Octans GA LLC c/o Butler Snow as developer/applicant.[2][3]
What is the proposed scale? Four buildings and 4.4 million square feet in the DRI. The $20 billion figure is estimated value at build-out, not verified financing available for contracts.[3][4]
When could it open? The owner describes phased development from 2028 through 2032, with initial capacity potentially online in 2028. Permits, infrastructure, financing and construction affect that target.[2]
Who is the general contractor? The owner FAQ still describes a competitive process to select a construction-and-operations partner.[2]
What is the power commitment? Georgia Power reports a contract covering 3,200 MW of new demand. The DRI separately estimates 3,210 MW of peak connected load.[8][4]
What jobs are forecast? The owner expects thousands of construction jobs, at least 400 initial permanent on-site jobs and more than 1,000 permanent roles at full build-out. These are forecasts, not current vacancies.[2]

The decisions to watch before committing crews or travel

This register separates a documented milestone from the permission or commercial agreement a reader would need to act. It is a selected public-record review dated October 29, 2026, not a complete permit inventory.

Decision or route What the evidence says What to check next
Regional development review DRI 4801 records a September 1 finding and completed regional review. Regional findings are advisory.[5][6] The applicable local approval and permit, not the DRI status alone.
Camellia site plan Tentative November 3 agenda item 2026-511, under XVI.16, lists consideration of Octans GA LLC’s application.[27] Final agenda, actual decision, conditions and approved drawings. Scheduled consideration is not approval.
County zoning rules The same agenda lists the zoning ordinance and map’s second reading under 2026-488, XV.2.[27] Adopted wording and its actual applicability to Camellia. This is separate from the site-plan item.
Federal wetland work Corps application SAS-2026-00872 was noticed October 5; written comments are due November 4.[24] Agency decision, any issued permit and the limits covering the proposed work.
Land-deal litigation The Effingham Herald reports an October 27 motion seeking to invalidate project-related agreements.[28] The court’s order and its scope. A party’s request is not a ruling.
Campus buyer and employer Owner pages provide supplier and talent-interest registration; the FAQ says partner selection remains underway.[2][13][14] A named purchasing entity and package, or a named employer and written job terms.

Download the October 29 decision register (CSV)

The November 3 county meeting agenda was explicitly tentative.[27] Its planning sections were marked for 6 p.m. The final agenda and meeting outcome have not been verified.[27] A date on this register should prompt a check of the outcome, not an assumption that the proposed action happened.

Has construction started?

The records reviewed for this report do not verify a campus construction start. The owner still describes significant work on the site plan, permits, financing and operating model, while the tentative county agenda lists the site plan for consideration.[2][27] The Corps document is an application notice, not an issued authorization for the proposed additional wetland impacts.[24]

That does not certify that every part of the property is untouched. The Corps notice identifies an earlier industrial-park permit issued January 19, 2023, which authorized some wetland and ditch impacts within the current review area.[24] A contractor should establish which permit, drawings and notice to proceed cover its particular work rather than infer campus readiness from visible site activity.

What the wetland figures mean

The Corps notice describes a 1,336.14-acre review area and 72.17 acres of proposed wetland impacts.[24] Of that wetland total, 22.07 acres were authorized under the earlier industrial-park permit; the application proposes 50.10 additional acres.[24] It also identifies 1.51 acres of ditch impacts authorized previously.[24]

Those units describe land and impacts, not building floor area.[24] They should not be substituted for the DRI’s 4.4-million-square-foot building total.[3][24] Likewise, the notice’s roughly 183.30-acre footprint for each large facility includes operational components; it is not a verified measurement of each building’s indoor floor space.[24]

The Corps public notice explains how to comment through the Regulatory Request System using SAS-2026-00872.[24] The deadline is November 4, 2026.[24] Sitework firms should obtain the issued authorization and approved impact limits before relying on a proposed footprint in an estimate.

Project Camellia regional review, power contract, county oversight and construction-partner selection milestones. Planned status, not a construction start notice.
Regional reviewDRI 4801 records a September 1 finding. Regional review is not a building permit.[5][6]
Power contractGeorgia Power reports 3,200 MW of new demand. Delivery is planned in phases between 2028 and 2032.[2][8]
County oversightCharles Abbott Associates provides county review and inspection support, not campus construction.[10][11]
Construction partnerThe owner still describes a competitive selection process.[2]
Diagram reviewed October 21; accompanying report updated October 29. Reported regional-review and power milestones are not a construction start notice.[2][5][8] County oversight is separate from campus construction.[10][11] Open full-size diagram

Who is involved, and who can buy construction work?

Organization Documented role Practical implication
OpenAI Leads campus design and development; describes partner selection as ongoing.[2] Follow its project channels for later partner and opportunity announcements.
Octans GA LLC Named developer/applicant in the DRI and applicant in the federal notice.[3][24] An applicant name does not establish which entity will sign a particular trade contract.
Effingham County Industrial Development Authority Listed as property owner in the initial DRI filing.[3] This historical filing is not a current title opinion or purchasing directory.
Georgia Power Utility counterparty for the reported power contract.[8] Its electrical-service role does not make it the buyer for every campus package.
Effingham County and Charles Abbott Associates County review and inspection authority, with CAA’s hiring reported by WTOC after the October 20 meeting.[7][10][11] CAA’s county-side role is not a campus general-contractor award.

The county packet describes CAA’s proposed initial review and inspection work for the first two planned buildings.[10] It also says that oversight scope need not match the builder’s schedule or tax-agreement phases.[10] Do not turn a reference to the county’s first phase into a construction mobilization date.

Contractors: register interest, then qualify the opportunity

The local-supplier page invites businesses to express interest and says the outreach team will provide further information when appropriate.[13] It does not identify a priced trade package, bid deadline or qualification decision.[13] OpenAI anticipates needs across construction trades, materials, equipment, maintenance, logistics and other services, but those categories are not an advertised bid list.[2]

Describe the work your company actually performs. Prepare a short profile with your service area, relevant projects, licenses, available crews, safety information and insurance or bonding capacity. These are preparation suggestions, not published Camellia qualification requirements.

Ask the project outreach team how to reach the buyer for your scope. The owner publishes outreachteam@projectcamellia.com as a contact route.[2] The Savannah Morning News reported an outreach office in Rincon on October 27; an outreach office is not a bid desk or a construction employer.[26]

Before spending time on an estimate, obtain answers to these questions:

Ask the prospective buyer Why it changes the decision
Which legal entity will sign the contract? Establishes who will owe payment and approve changes.
Is this an interest request, qualification review or priced bid? Determines how much estimating work is justified.
Which building, systems and exclusions are in the package? Prevents a general project description from becoming an assumed scope.
Which drawings, permits and authorized start apply? Connects the quoted work to an approved design and actual release.
What are the payment, retainage and change-order terms? Lets the contractor assess cash requirements before reserving capacity.

For example, a sitework contractor can submit its qualifications now while asking for the approved disturbance limits and drainage drawings. A supplier-interest confirmation alone would not justify reserving excavators or declining contracted work.

Workers: future interest is different from a job application

The Future Talent Network accepts information and resumes for future opportunities.[14] Its page says hiring will happen over time as the project advances.[14] This review did not verify a Camellia-specific craft opening with a named employer, requisition and start instructions.

An experienced worker can register skills and availability while pursuing confirmed employment elsewhere. Before traveling or accepting an assignment, obtain the employer’s name, exact reporting location, duties, pay, overtime rules, travel arrangements and start instructions. Neither the project’s permanent-job forecast nor an interest-form confirmation supplies those terms.

Regional training routes

The following providers offer routes into relevant trades.[16][19] None of these pages establishes a placement agreement with Project Camellia.

Provider Published application information Action before traveling or paying
Savannah Electrical Training Alliance Lists age and education requirements, a driver’s license, OSHA 10 construction certification, a physician appraisal and a $40 nonrefundable application fee. Applications are handled Wednesdays, 8:30–11 a.m. and 1–4 p.m., at 1526 Dean Forest Road, Savannah.[19] Review the full document list, annual training costs and current intake with the provider.
UA Local 188 Requires the TABE test before the in-person application and lists a $25 application fee. Its published annual application cutoff is July 1.[16] Ask about the next intake. The annual cutoff has passed for an October reader.

For opportunities beyond Camellia, compare the Echelon data-center project reports. Each project has its own evidence date and worker route; an employer lead on another campus is not a Camellia assignment.

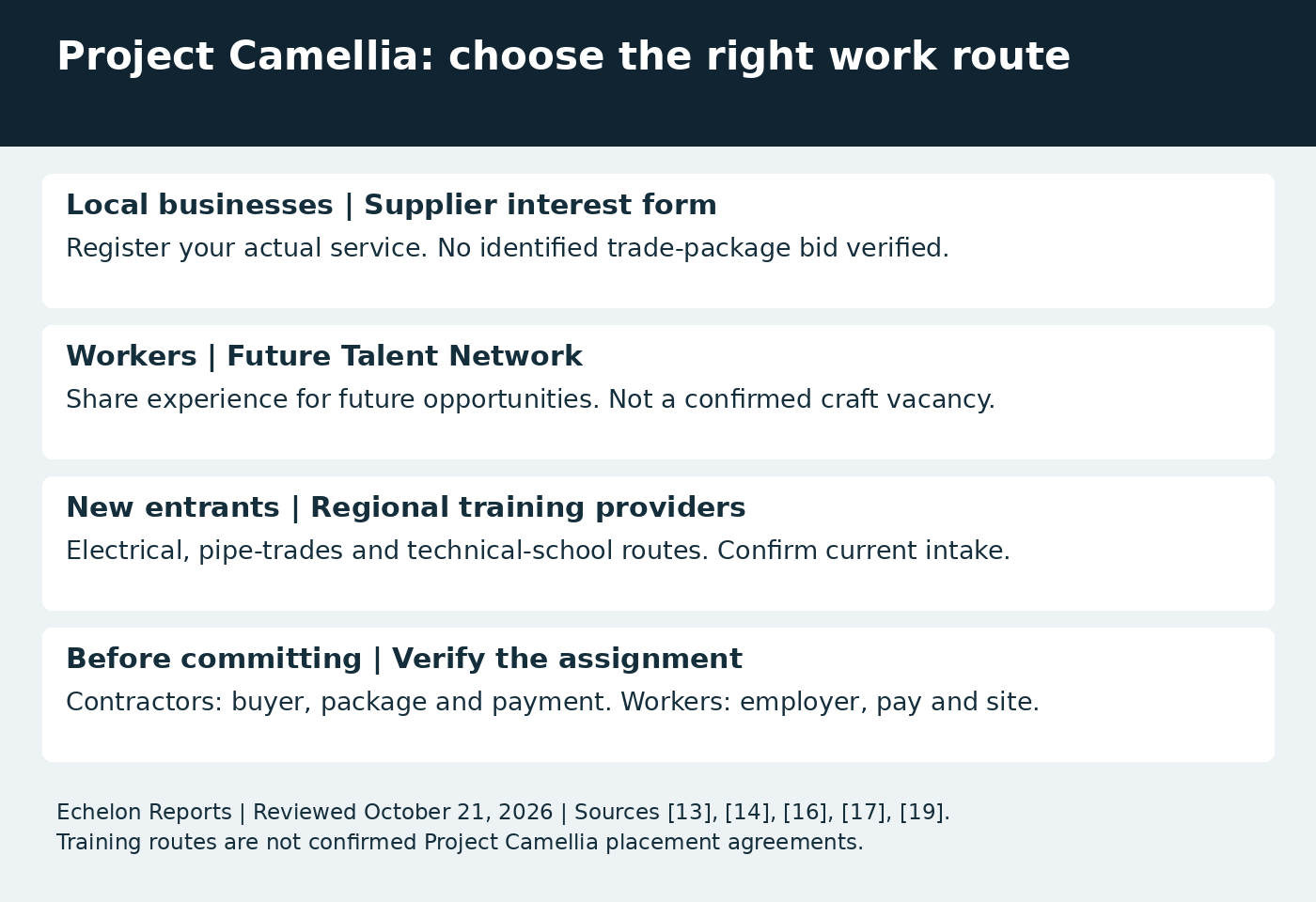

Project Camellia supplier interest, future talent and regional training routes. Registrations are not confirmed bids or jobs.
Local businessesUse the supplier interest form. Registration is not a bid invitation.[13]
WorkersUse the Future Talent Network for future opportunities, not a confirmed craft vacancy.[14]
New entrantsCheck regional electrical, pipe-trades and technical-school intake. Training is not a confirmed Camellia placement.[16][17][19]
Before committingContractors: confirm buyer, package and payment. Workers: confirm employer, pay and site.
Diagram reviewed October 21; accompanying report updated October 29. Supplier and talent registration are routes for future opportunities.[13][14] Confirm regional training intake before applying.[16][17][19] Open full-size diagram

The owner says Camellia is expected to be privately funded, while its FAQ still lists financing among the unfinished development work.[2] The DRI’s $20 billion estimate does not establish a financing close or money available to pay a contractor.[4]

Georgia Power’s reported contract covers 3,200 MW of new demand and up to 1,000 MW of flexible demand response.[8] Demand response allows reduced delivery during periods of high demand; it is not another 1,000 MW of generation.[8] The DRI’s separate 3,210 MW peak-connected-load estimate is a different planning measure, not a figure to add to the utility contract.[4]

Water demand also remains a design question. The DRI lists 30,000 gallons per day, while the owner explains that this recurring-use estimate excludes the initial fill of the closed-loop cooling system.[2][4] The initial fill and final ongoing annual demand are still being determined.[2][4] Closed-loop cooling should not be described as zero water use.

Two lawsuits, different challenged actions

The September 2 zoning case challenges Ordinance 2026-352, approved August 4.[21] Local reporting says the county sought dismissal on October 2.[21][22] The separate September 21 case concerns the development authority’s land transaction and alleged open-meetings and open-records violations.[18]

In that second case, the Effingham Herald reports that plaintiffs filed an October 27 summary-judgment motion seeking to invalidate project-related agreements.[28] Summary judgment is a request for a court decision without a trial.[28] The report describes the plaintiffs’ arguments, not a ruling, and says the motion itself does not halt the project.[28] Echelon has not independently inspected the original motion or a current court docket.

Zoning discussions require the same care. The Herald reported discussion of a possible moratorium on future data centers; the tentative November 3 agenda scheduled the ordinance and map’s second reading.[20][27] Neither source establishes an enacted Camellia-specific construction stop. Check the adopted text and any actual court order before changing a contract decision.

Keep the next step specific

Contractors can register a defined service and ask for the purchasing route. Workers can express interest without treating the project as an available job. Use the Echelon project guide and update-request options to follow relevant reports; requesting updates is separate from applying for work.

If you want Echelon to know what work you would consider, submit a private worker-interest form. It is not a Camellia application. The form explains that permission is required before a profile is shared with a named employer or recruiting partner. Employers with a defined licensed-trade requirement can submit a Hiring Mandate.

Method and update note

Prepared by Echelon Reports from public records and published sources reviewed through October 29, 2026. The review combines owner statements, Georgia DRI records, utility disclosures, county materials, the federal permit notice and attributed local reporting. Future agendas, forecasts and parties’ legal arguments remain labeled as such.

The decision register is a dated research aid, not a complete permit search, title opinion, construction award list or vacancy feed. No project forms were submitted, and no employer confirmed a vacancy directly to Echelon. Sources dated before this review retain their original event dates. The November 3 agenda and November 4 comment deadline require outcome checks after those dates.

Sources

  1. Project Camellia
  2. DRI Initial Information Form
  3. DRI Information Form Part 2
  4. DRI Application Summary
  5. Developments of Regional Impact: Coastal Regional Commission
  6. Understanding the Process: What Happens Next for Project Camellia?
  7. Georgia Power’s contract with OpenAI approved; Latest approval part of portfolio of large-load contracts delivering approximately $950 million in annual savings beginning in 2029
  8. County October 20 packet
  9. Effingham County hires firm to oversee Project Camellia data center
  10. Local supplier interest
  11. Future talent network
  12. UA 188 apprenticeship
  13. Savannah Tech Effingham
  14. September 21 complaint: One Hundred Miles and residents v. ECIDA and Octans GA
  15. Savannah Electrical Training Alliance: current application process
  16. Effingham Herald: October zoning debate and November 3 reading
  17. Effingham Herald: September 2 zoning lawsuit
  18. The Georgia Virtue: county seeks dismissal of zoning case
  19. U.S. Army Corps of Engineers: October 5 public notice, SAS-2026-00872
  20. Savannah Morning News: October 27 Rincon project office report
  21. (Tentative) Board of Commissioners Regular Meeting Agenda 11/03/2026 05:00 PM
  22. OpenAI Data Center Plaintiffs Ask Judge to Void Land Deal

Echelon Trades Jobs

Hiring or looking for work in the trades?

Employers can submit an opening for review. Tradespeople can tell us what work they want. Both are free, and worker profiles stay private.

Post a free job Tell us what work you want

Visit Echelon Trades Jobs
