Project Jupiter New Mexico: Contractors, Jobs and Permits

Research checked October 16, 2026. Contractor-role amendment: November 7, 2026, using Kiewit’s October 22 announcement.

Permit-process update: November 7, 2026. NMED’s November 6 order vacated the December 7 microgrid hearing and its associated pre-hearing deadlines. The application remains under review; this order does not issue an air permit.[45]

Clayco and Kiewit New Mexico Co. were building Project Jupiter in Santa Teresa at the October 16, 2026 research check. Contractors had separate routes for campus work, the proposed power system and local vendor introductions. The proposed fuel-cell microgrid still had a pending air-permit application on October 15, and reporting published October 16 said generation construction had not started.[27][25][8]

That distinction matters if you are pricing a subcontract, hiring a crew or deciding whether to travel. An active campus does not mean every connected package has permission to proceed. A projected workforce does not tell you which employer has an opening this week.

For local firms, the project has a vendor-interest form.[19] For workers, its careers page connects to STACK, Oracle and Bloom Energy.[20] The employer descriptions below preserve the October 16 research record, not a list of jobs confirmed open today.[21][23]

Start here: bidding firms and workers need different routes

Your goal Verified starting point What it does
Introduce a local contracting or service business Project Jupiter vendor interest Collects Doña Ana County-area business details for project teams. It is not an open bid or approval to work.[19]
Find an employer application Project Jupiter careers Links to STACK, Oracle, Bloom and a construction-careers destination. Each employer controls its applications.[20]
Pursue facilities operations work STACK Critical Operations Technician, JR00150 Santa Teresa listing with a posted $40–$53 hourly range. This is an operations role, not a construction dispatch call.[21]
Ask about craft referrals Trade-hall directory below Provides official regional contacts. Confirm the actual employer, project and current call before traveling.
Check licensing before offering work New Mexico Construction Industries Division State licensing and regulatory starting point. The Las Cruces office is (575) 524-6320.[24]

The vendor form asks for business name, contact, phone, email, employee count, years in business and services offered. Its disclaimer expressly says that submission guarantees neither a contract, vendor status nor employment. Small firms can use it to introduce their capabilities, but should not budget around an award that has not been made.[19]

Back to article index

Project Jupiter at a glance

Project detail What contractors and workers should know
Location Santa Teresa, Doña Ana County, New Mexico, on the New Mexico side of the El Paso border region.[1]
Physical development Four main data-center buildings across a reported 1,400-acre development.[40]
Initial phase County agreement summary describes an initial 400-acre phase. This is not the same counting scope as the full development.[2]
Construction participants Clayco and Kiewit New Mexico Co., according to Clayco founder Bob Clark’s September 30 account.[27]
Initial capacity target Fourth quarter of 2026 in the county agreement summary; not verified achieved.[2]
Initial-phase completion target Third quarter of 2028, including the microgrid, in the county agreement summary.[2]
Power constraint The November 6 order vacated the December 7 microgrid air-permit hearing. A revised Air Quality Bureau recommendation must be filed before the hearing can be rescheduled.[45]

View Santa Teresa on a regional map. This identifies the community, not an approved construction entrance or delivery route. Obtain the reporting address, gate assignment and truck-access instructions from your employer or package holder before arrival.

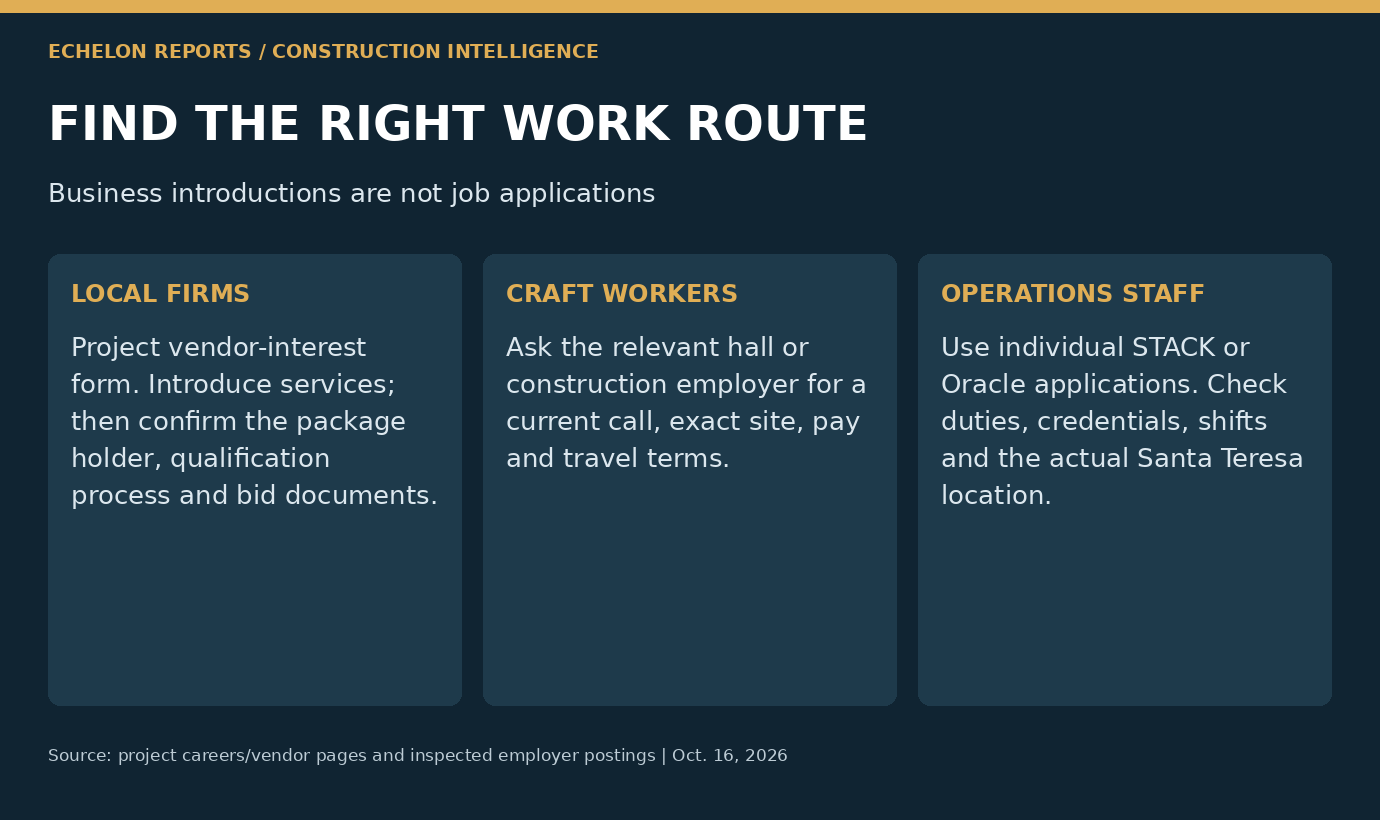

Business introductions are not job applications. LOCAL FIRMS: Project vendor-interest form. Introduce services; then confirm the package holder, qualification process and bid documents. CRAFT WORKERS: Ask the relevant hall or construction employer for a current call, exact site, pay and travel terms. OPERATIONS STAFF: Use individual STACK or Oracle applications. Check duties, credentials, shifts and the actual Santa Teresa location.
Choose the route that matches your purpose. Interest registration is not a bid or job offer. View full-size graphic

Back to article index

What Project Jupiter is, and who does what

Project Jupiter is a data-center campus in Santa Teresa, Doña Ana County, near the Texas and Mexico borders. The county identifies STACK Infrastructure and BorderPlex Digital Assets as its project leaders. OpenAI identifies the Doña Ana County site as part of its Stargate expansion with Oracle.[1][17]

The project combines data-center buildings with a proposed on-site power system. Treat the campus, microgrid, gas supply and public infrastructure commitments as related workstreams, not as one contract with one start date.

Organization Supported role Contracting implication
STACK Infrastructure Data-center infrastructure delivery; its announcement identifies investment from funds managed by Blue Owl Capital.[16] A developer-side route, not proof that STACK directly holds every trade contract.
BorderPlex Digital Assets Development partner identified by the county.[1] Project leadership does not establish a specific subcontract award.
Oracle Cloud infrastructure participant and project spokesperson; publishes local careers and current project disclosures.[5][20] Oracle employment is separate from a construction contractor’s hiring or procurement.
OpenAI Identifies the New Mexico site within Stargate.[17] The Stargate name is not a bid-submission channel.
Clayco and Kiewit New Mexico Co. Campus construction participants named by Clayco founder Bob Clark.[27] Kiewit identifies a Clayco and Kiewit joint venture as general contractors for the first 855,000-square-foot portion in its October 22, 2026 announcement.[44] Confirm the package holder for other buildings, power-system work and individual trades.
Yucca Growth Infrastructure Applicant associated with the microgrid air-permit proceeding.[6][25] Generation permits and contracts must be checked separately from campus buildings.
Bloom Energy Fuel-cell technology identified in the proposed power design.[25] Equipment supply, installation and operating employment are different opportunities.

In a September 30 first-person column, Clark said Clayco and Kiewit had placed the final structural beam on the first 855,000-square-foot portion of the campus. That is useful evidence of construction participation. It does not identify every electrical, mechanical, civil or fire-protection subcontractor.[27]

The sources reviewed do not provide a complete package-by-package contractor list. Ask for the legal contracting entity, building or work area, package number and procurement contact before sending pricing or accepting instructions to mobilize.

Back to article index

Where the work stands: buildings, generation and gas supply

The county’s agreement summary anticipates initial capacity in the fourth quarter of 2026 and completion of the initial 400-acre phase, including the microgrid, in the third quarter of 2028. Those are anticipated milestones, not a certification that either target has been achieved.[2]

Searchlight New Mexico’s account of an October 13 site tour describes campus construction underway while the proposed microgrid awaited an air-quality permit. Its October 16 report expected the permit hearing to begin December 7.[8] NMED’s November 6 order has since vacated that date.[45]

Oracle and Yucca Growth Infrastructure announced another design refinement on October 15. Their release describes a proposed operating cap and says the supplement was submitted to a pending permit application. Although the release’s headline uses the phrase “permitted emissions,” the body does not announce an issued permit.[25]

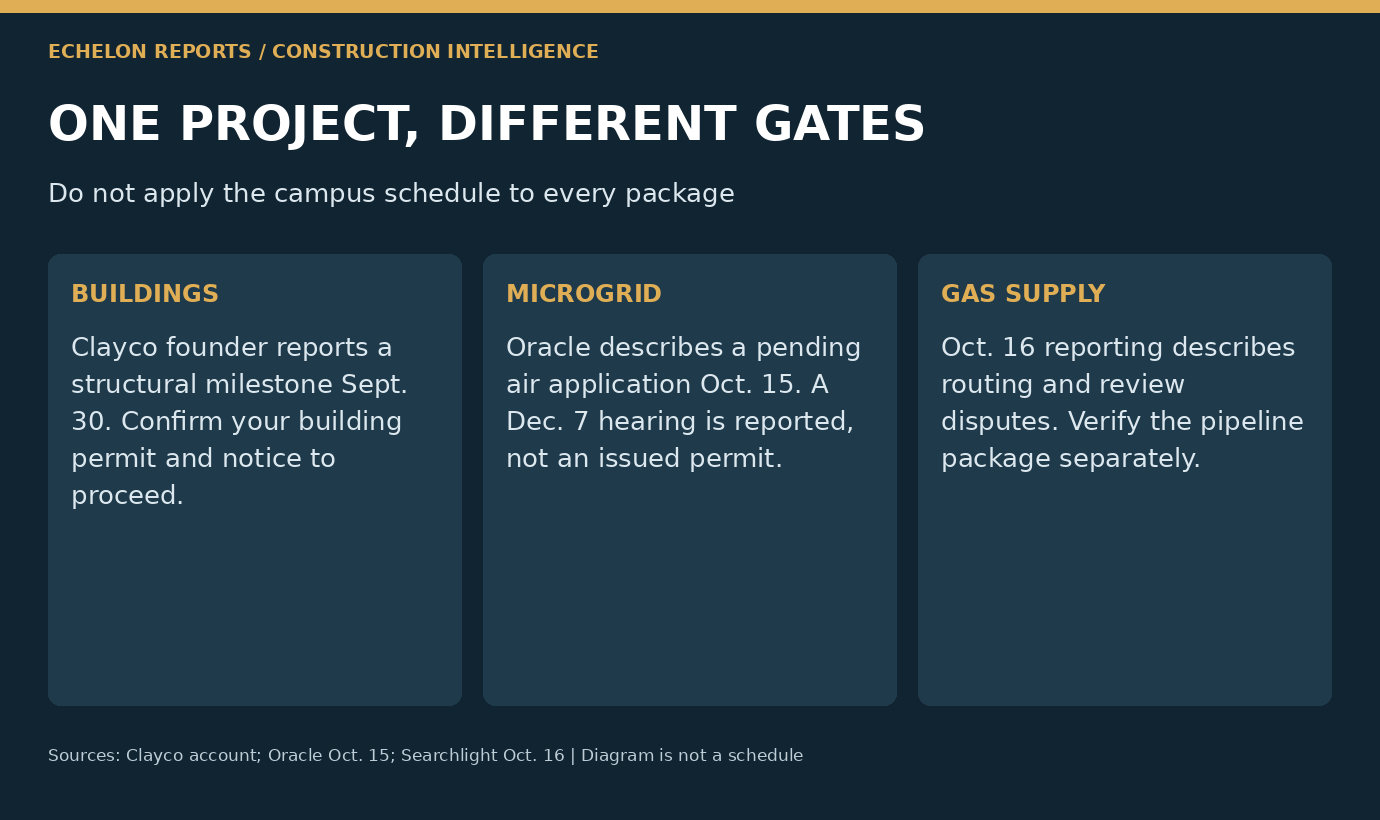

Before accepting a notice to proceed, check which permitted scope it covers. Permission to grade a site does not establish permission to install generation equipment or begin commissioning. Obtain the permit and written authorization for the specific work you plan to perform.

Workstream Evidence available on October 16 What to verify before committing resources
Campus buildings Construction participation and structural milestone reported by Clayco’s founder; October site reporting describes continuing work.[27][8] Exact building, current drawings, issued permits and authorized package holder.
Fuel-cell microgrid October 15 applicant release calls the air-permit application pending.[25] Issued permit, conditions, equipment release and installation authorization.
Gas supply October 16 reporting describes pipeline routing and federal-review disputes.[8] Approved route, responsible pipeline entity and the package’s actual notice to proceed.
Commissioning and operations Employers advertise Santa Teresa facilities roles.[21][23] Start date, energized-system readiness, shift pattern and whether the position supports construction turnover or permanent operations.

The public NMED case is AQB 26-57(P), Yucca Growth Infrastructure, associated with air-permit application NSR 10833. Use the official docket to check subsequent orders and filings. A filing in that docket is not itself permission to install or operate equipment.[6]

On November 6, hearing officer James Browning granted YGI and NMED’s joint motion to vacate the December 7 air-permit hearing and its associated pre-hearing deadlines. YGI expressly waived the application decision deadline. The hearing will not be rescheduled until the Air Quality Bureau files its revised recommendation in the administrative record. If the bureau recommends issuing a permit, that filing must include an amended draft permit, statement of basis and modeling report.[45]

Browning denied the renewed dismissal motions from New Energy Economy and the Center for Biological Diversity. The application remains in the proceeding, but the order does not approve the permit or authorize generation construction. It requires NMED to supplement the record at least weekly and sets the first status conference for November 19, 2026 at 11 a.m. Mountain Time. That conference is not a replacement permit hearing.[45]

A further permit-process risk to watch

Source New Mexico reported October 14 that Attorney General Raúl Torrez had questioned the authenticity of a substantial share of comments on the air-permit application. His letter requested verification of the record and said reopening public comment should be considered if the records could not be verified. The report also quotes his explicit limitation: the letter does not establish who was responsible for a particular comment or characterize anyone’s intent.[39]

For contractors, this is another reason to follow actual hearing orders rather than assume a permit date. It does not establish a new construction shutdown or a fixed additional delay. Keep any standby and remobilization terms tied to your own contract and authorized work.

Campus, generation and gas-supply work have separate approval requirements. The November 6 microgrid order vacated the December 7 hearing; it did not issue an air permit.[45]

Back to article index

Which trades should investigate which scopes

The following is a practical scope map, not a list of currently open packages. It combines documented campus systems and construction activity with the questions a trade contractor should resolve before bidding.[21][25][27]

Trade or service Scope to investigate Important boundary
Civil, excavation and underground utilities Site access, grading, drainage, underground services and remaining civil packages Determine whether work belongs to the campus, microgrid or a separate utility project.
Concrete, rebar, carpentry and structural steel Remaining buildings, equipment foundations and structural modifications A completed structural milestone does not establish that later packages remain available.
Electrical and instrumentation Distribution, switchgear, controls, testing and equipment connections Separate building electrical work from generation installation and energization.
Plumbing, pipefitting and mechanical Closed-loop cooling, pumps, piping, water treatment and mechanical installation Obtain actual system specifications; promotional water comparisons are not design documents.
Sheet metal and HVAC Air-handling systems, ductwork, equipment installation and service Confirm the mechanical package holder and whether hiring is through a hall or directly.
Fire protection and life safety Sprinkler systems, detection, inspections and turnover documentation STACK’s operations posting describes these systems, not an available installation contract.
Fiber, low voltage and controls Cabling, network infrastructure, building monitoring and integrated testing Verify scope boundaries with electrical and equipment vendors.
Operators, riggers and laborers Equipment operation, material movement, lifts and construction support Confirm employer, equipment qualifications and the current work area.
Testing, commissioning and technical training Functional testing, acceptance records, operating procedures and staff preparation Operations recruitment can begin before systems are ready for service.
Logistics and local services Deliveries, consumables, equipment support and site-service proposals Use the vendor-interest route, then establish an actual buyer and purchase order.

For a small contractor, a precise capability statement is more useful than a general claim that you can handle data centers. Identify your licensed scope, relevant industrial work, crew and supervision capacity, safety record, insurance and the geographic area you can serve. Ask which procurement system the package holder actually uses.

Back to article index

Direct contractor qualification and bid-discovery routes

Clayco and Kiewit publish their own supplier entry points. These are more useful than sending a capability statement to an unrelated corporate inbox, but neither establishes an open Jupiter package.

Company Direct route Prepare before starting
Clayco Subcontractor and vendor prequalification, including its Preconstruction Contractor Profile Form and public plan room Clayco requires annual qualification. Its BuildingConnected plan room also requires a profile. Ask which Jupiter package holder controls your scope before pricing.[41]
Kiewit Supplier registration and profile guide, with instructions for GEP SMART Prepare company identity, service categories, operating regions, contacts and certificates. Accurate categories help buyers find your firm for sourcing and bidding.[42]

Registration starts the qualification process. An actual bid needs a named buyer, defined scope, drawings, submission instructions and deadline. We did not verify a publicly open Jupiter solicitation with those details.

Back to article index

Construction supervision lead near Santa Teresa

Kiewit’s Project Superintendent – Building Group, requisition 179357, says its initial project is in the El Paso/Santa Teresa area. The listing seeks electrical, mechanical/electrical/plumbing (MEP), civil and structural superintendents. Responsibilities include supervising craft personnel, coordinating subcontractors, planning staffing and checking safety, quality and schedules.[43]

It asks for at least five years of construction experience, including three years in supervision, and experience overseeing subcontractors as a general contractor. Kiewit describes relocation or per diem/trips-home options for this role. Those terms do not establish benefits for other workers or packages.[43]

Read Kiewit requisition 179357. This is a local construction-management lead, not a verified Jupiter assignment or craft dispatch. Confirm the exact project with the recruiter. Our additional search did not verify an individual craft opening that explicitly names Jupiter.

Back to article index

Santa Teresa job descriptions recorded October 16

These employer pages were inspected on October 16. A visible application page is a recruiting lead, not confirmation that a position remains unfilled. Neither a job title nor a salary range guarantees an offer.

STACK: Critical Operations Technician, JR00150

The October 16 Santa Teresa posting covered day-to-day data-center operations. Duties include mechanical and electrical systems, controls, preventive maintenance, incident response and fire-life-safety monitoring. STACK lists $40–$53 per hour across technician levels I, II and III, with the offered rate tied to qualifications.[21]

The posting requires a high-school diploma or equivalent and three to five years of related mission-critical experience. It describes variable hours, possible on-call work, background screening and less than 5% travel. The displayed application end date is December 31, 2026, but an applicant should recheck the employer page rather than rely on that date alone.[21]

Check the STACK technician listing.

Oracle: Facilities Operations Technician IV, 333921

Oracle’s posting explicitly places this job onsite in Santa Teresa. It covers electrical, mechanical, cooling and controls systems, with troubleshooting, maintenance, upgrades and commissioning support. The listing requires U.S. citizenship and says visa or work-permit sponsorship is unavailable.[23]

Trade experience, apprenticeship completion or equivalent practical experience is preferred. The page lists a broad U.S. annual hiring range of $91,400–$187,000, with compensation dependent on experience and other factors. This is not a guaranteed Santa Teresa offer or a construction wage schedule.[23]

Check Oracle job 333921.

STACK: Technical Trainer, JR00334

STACK’s Santa Teresa Technical Trainer posting described a route for experienced tradespeople with training backgrounds. It includes hands-on instruction in electrical, mechanical, controls and safety systems, equipment walkdowns and preparation for system handoff.[22]

The posting lists five or more years of relevant training experience, a degree or equivalent hands-on experience, and up to 30% domestic travel. Its displayed compensation range is $109,000–$121,000, with an October 31, 2026 application end date that has now passed. This retained description does not establish that applications remain open.[22]

Check the dated STACK trainer listing.

The project’s careers page also links to Bloom Energy recruitment. Its “Construction Careers” link leads to STACK’s general careers page; it should not be mistaken for a project-specific list of craft vacancies.[20][36]

Back to article index

Union halls and regional craft contacts

SMART Local 49 says Project Jupiter is putting its members to work.[28] The project’s FAQ names UA 412 and the Carpenters among unions supporting construction.[26] Oracle’s October release quotes Carpenters Local 1319 leadership, but we did not verify a direct Local 1319 referral contact.[5]

Those statements do not establish a current referral call. Other halls below are official regional contacts whose Jupiter assignments were not confirmed in this research. Ask each hall about the exact project, employer, referral rules and current availability.

Trade Official route Contact and evidence boundary
Sheet metal SMART Local 49 (505) 266-5878 ext. 0. The union has published a Jupiter-specific account; its contact page links an out-of-work portal.[28][29]
Plumbing and pipe trades UA Local 412 Las Cruces satellite: (575) 382-5140. Main hall: (505) 265-1513. Contractor dispatch contact appears on the official page.[30]
Electrical IBEW Local 611 (800) 287-2545. The Albuquerque office handles referral; confirm the applicable jurisdiction and employer.[31]
Equipment operators IUOE Local 953 (505) 266-5757. Regional inquiry and membership route, not a verified Jupiter vacancy.[32]
Ironworkers Ironworkers Local 495 (505) 242-9124. Ask about project-specific calls and requirements.[33]
Laborers LIUNA Local 16 (505) 265-7933. Regional hall contact; a current Jupiter dispatch was not verified.[34]

Apprenticeship enrollment, union membership and dispatch are different processes. Someone entering a trade should ask about training admission and paid placement separately. A traveler should obtain a current call, not travel solely because a project announcement mentions thousands of jobs.

Back to article index

Before you bid or leave home

New Mexico’s Construction Industries Division says it requires licensure for those practicing or offering to practice construction contracting. Use CID to confirm the required business classification and any individual trade credentials for your scope. Do not assume that a Texas license or a union card settles New Mexico requirements.[24]

For firms, resolve these items before committing equipment or accepting a start date:

  • The exact legal buyer, contract tier and person authorized to issue changes.
  • Building, work area, drawings, exclusions and the boundary between campus and power-system work.
  • Applicable permits and a written notice to proceed for your package.
  • Payment timing, retainage, stored-material terms and responsibility for delays.
  • Bonding, insurance, safety orientation and documentation requirements.
  • Who bears standby, demobilization and remobilization costs if power or permits delay your scope.

El Paso Matters reported a conditional provision that could allow Oracle to defer some rent payments if power is not delivered on time. That report concerns a tenant-landlord arrangement. It is not evidence that a subcontractor has gone unpaid, and this research did not establish project liens or unpaid trade invoices.[10]

For workers, confirm the employer and job location before arranging lodging. Ask about base pay, overtime rules, expected weekly hours, shift, per diem, travel reimbursement, parking, shuttle access and cancellation terms. The inspected sources do not establish a project-wide per diem or housing guarantee. Obtain those terms from the actual employer or hall.

Back to article index

What the workforce numbers really mean

Oracle’s October 13 release reports 4,393 workers had contributed more than 3.75 million labor hours, including 1,230 New Mexico residents and 630 Doña Ana County residents. Those are cumulative reported participation figures, not a count of simultaneous openings.[5]

The same release projects 7,000 construction jobs at peak. That is a forecast, not 7,000 jobs available to applicants today. Older county materials use different employment commitments and time frames; they should not be combined into a single vacancy total.[5][2]

Oracle also says its paid, 12-week Catalyst training program will begin in 2027 and require no college degree or prior data-center experience. Treat that as an announced future pathway, not proof that enrollment is currently open.[5]

For more regional project comparisons, see Echelon’s data-center construction reports, including Abilene Stargate and xAI’s Memphis-area buildout. Their employers, permits and application routes are separate from Jupiter’s.

Back to article index

Frequently asked questions

Who is building Project Jupiter in New Mexico?

The county identifies STACK Infrastructure and BorderPlex Digital Assets as project leaders. Kiewit’s October 22, 2026 announcement identifies Clayco and Kiewit New Mexico Co. as the general contractors for the first 855,000-square-foot portion of Project Jupiter. It says the Clayco and Kiewit joint venture was selected by Oracle and STACK Infrastructure in August 2025. This establishes a joint-venture role for that portion, not the contracting arrangement for every campus building, power-system work or subcontract.[1][44]

How can a contractor pursue Project Jupiter work?

Doña Ana County-area businesses can submit the official vendor-interest form. It collects business and service details but explicitly guarantees neither a contract, vendor status nor employment. Confirm the package holder and qualification process before treating it as a bidding opportunity.[19]

Are there verified Project Jupiter-area jobs for skilled tradespeople?

At the October 16 check, STACK and Oracle advertised Santa Teresa facilities roles with electrical, mechanical and controls duties. STACK’s technician posting lists $40–$53 per hour across three levels. These are employer recruitment listings for operations, not confirmation of construction dispatch openings.[21][23]

Is Project Jupiter’s power plant approved?

NMED’s November 6 order vacated the December 7 microgrid air-permit hearing and its associated pre-hearing deadlines. The application remains under review; the order does not issue an air permit. The first status conference is November 19, 2026 at 11 a.m. Mountain Time, not a replacement permit hearing.[45]

Does the 7,000-job projection mean 7,000 openings now?

No. Oracle projects 7,000 construction jobs at peak. Its separately reported 4,393 workers are cumulative participants. Neither figure is a current vacancy count.[5]

Should workers travel before receiving a confirmed call or offer?

Obtain confirmation from the employer or hall first. Establish the site, start date, credentials, pay, expected hours and travel terms. This research did not verify a project-wide per diem, lodging benefit or guarantee of dispatch.

Back to article index

Sources and research method

This report combines county project information, developer and employer disclosures, the NMED docket, official trade-hall contacts and dated local reporting. Research was checked October 16, 2026. Employer postings can close, dispatch calls change and permit schedules move.

Project-linked roles are distinguished from regional inquiry routes. Construction participation does not establish a particular contract tier; projected jobs are not vacancies. The scope table is a guide to questions and potential work categories, not a solicitation list. We did not submit applications, register vendors or contact employers on a reader’s behalf.

Back to article index

Sources

[1] County identity

[2] Dona Ana County, NM

[5] Project Jupiter is Expected to Generate more than $13 Billion in Economic Impact for New Mexico

[6] AQB 26-57(P): Yucca Growth Infrastructure, LLC

[8] Oracle touts Project Jupiter benefits during tour as wrangling over power continues

[10] Oracle could defer Project Jupiter rent payments over power supply delays

[16] STACK Infrastructure Delivers Digital Infrastructure for Data Center Campus in New Mexico

[17] OpenAI, Oracle, and SoftBank expand Stargate with five new AI data center sites

[19] Project Jupiter vendor interest

[20] Project Jupiter careers

[21] https://stackinfra.wd108.myworkdayjobs.com/en-US/STACK_AMER/job/Santa-Teresa-NM/Critical-Operations-Technician_JR00150

[22] https://stackinfra.wd108.myworkdayjobs.com/en-US/STACK_AMER/job/Santa-Teresa-NM/Technical-Trainer_JR00334

[23] https://careers.oracle.com/en/sites/jobsearch/job/333921

[24] https://www.rld.nm.gov/construction-industries

[25] https://www.oracle.com/news/announcement/project-jupiter-microgrid-cuts-permitted-emissions-by-35-percent-2026-10-15

[26] https://projectjupitertogether.com/faqs

[27] Clayco founder firsthand commentary

[28] SMART Local 49 Jupiter story

[29] SMART Local 49 contact

[30] UA Local 412 contact

[31] IBEW 611 locations

[32] IUOE Local 953 international directory

[33] Ironworkers 495 contact

[34] LIUNA Local 16 contact

[36] STACK career destination

[39] https://sourcenm.com/2026/10/14/new-mexico-ag-finds-substantial-share-of-project-jupiter-public-comments-raise-concerns

[40] https://www.krqe.com/news/new-mexico/project-jupiter-leaders-show-construction-progress-on-data-center

[41] https://claycorp.com/contact-us/subcontractor-pre-qual

[42] https://www.kiewit.com/wp-content/uploads/2025/11/Supplier-Registration-Guide-English.pdf

[43] https://kiewitcareers.kiewit.com/job/Santa-Teresa-Project-Superintendent-Building-Group-NM-88008/1356643300

[44] Kiewit: Clayco and Kiewit Reach Major Construction Milestone at Project Jupiter Data Center Campus. October 22, 2026; reviewed November 7, 2026.

  • NMED, AQB 26-57(P): November 6, 2026 order on various motions. Vacates the December 7 hearing and pre-hearing deadlines; sets the November 19 status conference.
  • Back to article index

    Echelon Trades Jobs

    Hiring or looking for work in the trades?

    Employers can submit an opening for review. Tradespeople can tell us what work they want. Both are free, and worker profiles stay private.

    Post a free job Tell us what work you want

    Visit Echelon Trades Jobs
