The Barn data center in Saline Township: contractors, union calls and jobs

Updated November 16, 2026. Dispatch checked November 15 for November 16. Earlier observations retain their dates.

IBEW Local 252’s November 16 call sheet advertises 48 journeyman inside wireman positions and 10 separate RESA Power test-technician positions at The Barn data center in Saline Township, Michigan. We checked the sheet on November 15.[11] Read the hall’s current calls and referral instructions before traveling, because advertised positions can be filled or changed.[11][12] For contractors, Walbridge publishes a general prequalification route, although we have not verified an open Barn bid package.[4]

The Barn is under construction in Washtenaw County, on the north side of Michigan Avenue near Bridgewater Township.[9] Related Digital is the developer, Walbridge is the general contractor, and Oracle and OpenAI are the intended users.[9][3] The campus belongs to OpenAI’s Stargate program.[1] This report covers the Michigan project; Echelon’s Abilene Stargate report covers the separate Texas campus.

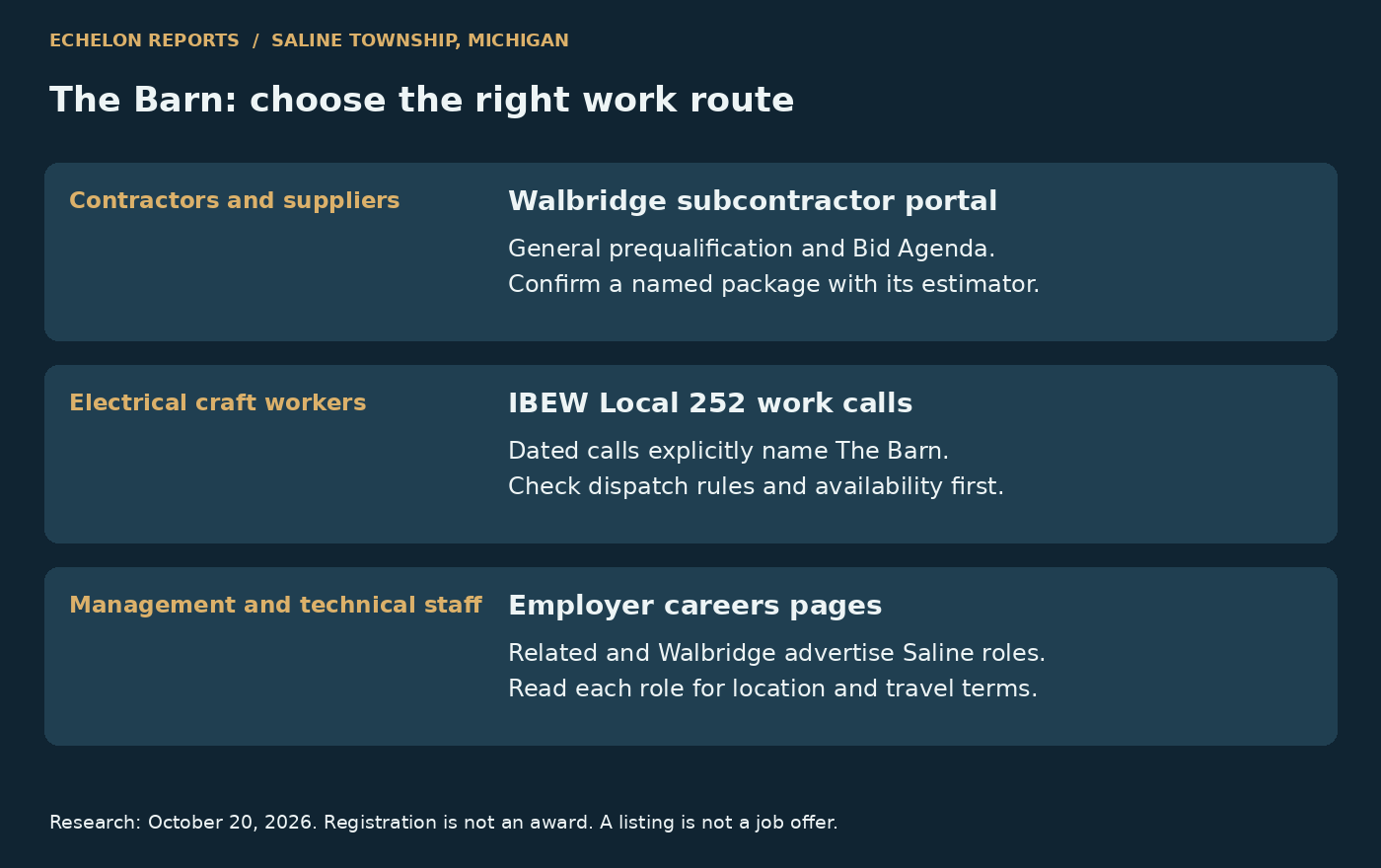

Separate contractor, electrical craft and professional hiring routes for The Barn in Saline Township.
Contractor registration and worker dispatch serve different purposes. Sources: Walbridge, IBEW Local 252, Related careers.

What is being built, and when?

The Barn is an announced $16 billion campus. On April 24, Related Digital and Blackstone announced that financing had been secured, with equity from Related Digital and Blackstone-affiliated funds and debt anchored by PIMCO-managed funds and accounts.[18] The announcement said closing remained subject to customary conditions; it did not confirm a completed financing close or final construction cost.[18]

Walbridge describes three single-story data halls of 550,000 square feet each, totaling 1.65 million square feet.[3] On June 1, Related Digital said all three buildings were under construction and the first was nearing completion.[7] Its ceremonial groundbreaking that day was not the start of construction: Walbridge had already reported more than 200,000 union trade hours by May 5.[3][7]

The project website says construction continues through 2027 with phased delivery.[2] That is a project schedule, not a verified date for each hall’s opening or energization.[2] OpenAI calls the campus a 1-gigawatt project.[1] The Michigan Public Service Commission (MPSC) separately describes a 1,383-megawatt contracted electrical load.[6] Those figures have different meanings and should not be used interchangeably.[1][6]

Land figures also use different boundaries.[9][3][2] The township’s January 28 FAQ describes an approximately 575-acre project site on eight properties.[9] Walbridge refers to the 250-acre construction campus, while the project website describes more than 1,000 acres in its wider land assemblage, with about 250 developed.[3][2] Neither the smaller nor the larger number is a substitute for the other.[9][2]

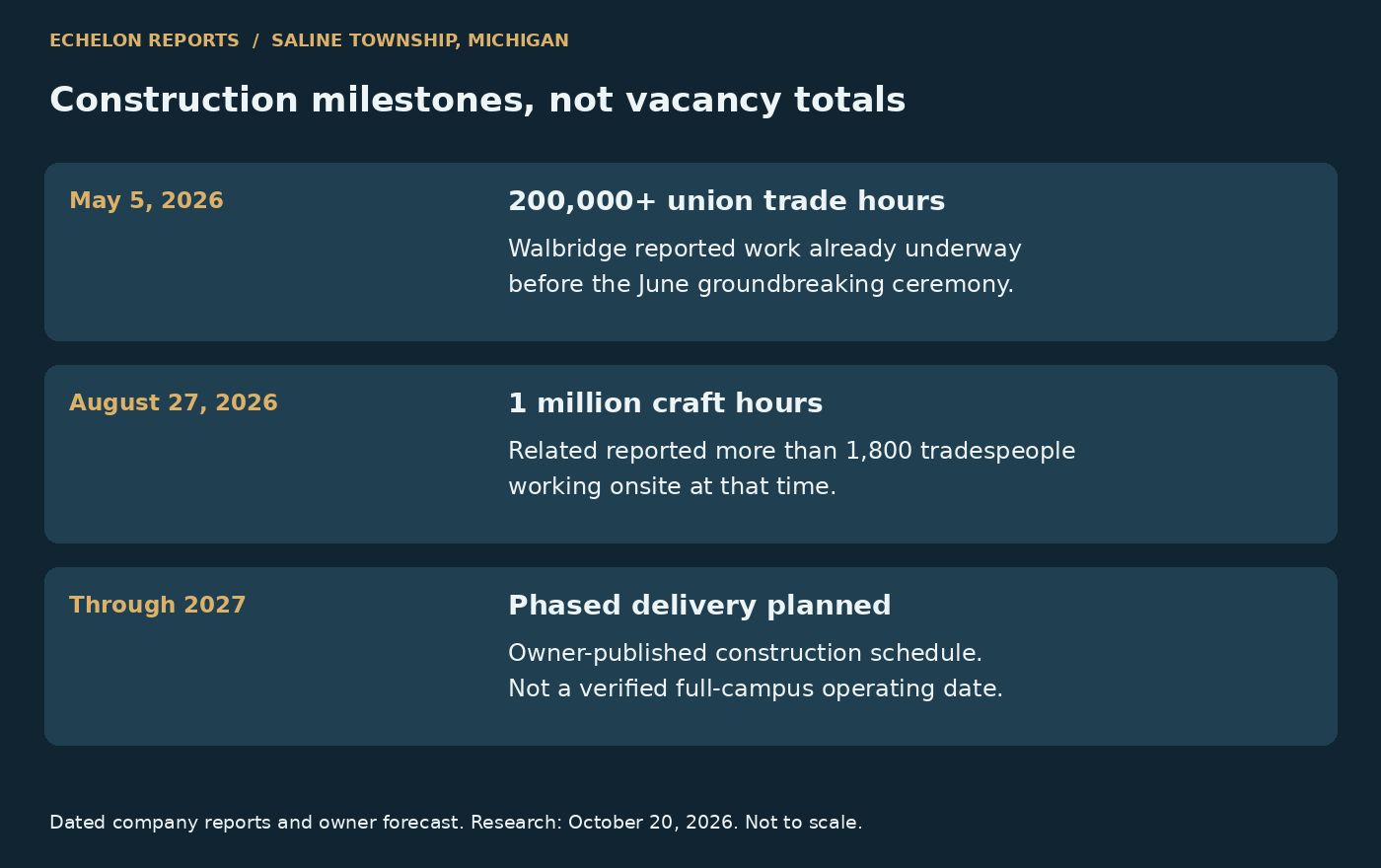

Dated construction milestones for The Barn, separating reported work hours and workforce from planned delivery through 2027.
Construction reports and planned delivery have different dates. Sources: Walbridge, May 5, Related, August 27, Project website.

Which contractors are named?

Walbridge’s May 5 release identifies Kais-Air as responsible for mechanical and electrical skid assemblies and hot aisle containment.[3] It also names Motor City Electric, Progressive Mechanical Inc. (PMI), John E. Green, Shaw / E-J Electric, Superior Electric Great Lakes (SEGLC), Triangle Electric and Universal Piping Industries (UPI) as trade partners.[3] The release names partners, not a list of every subcontractor or every open scope.[3] These firms do not all perform electrical work.[3]

ENR separately reports that Blaze Contracting handles earthwork, attributing that assignment to Related Digital.[19] This is a reported contractor assignment, not an open bid or hiring notice.[19]

The October 21 Local 252 call sheet named employers on specific electrical and testing calls, including Motor City Electric, Shaw, Superior Electric Tri County, Triangle, VEC and RESA Power.[11] A hall call names an employer seeking dispatch on that date; it does not establish the employer’s full contract scope or revise Walbridge’s May partner list.[11][3] In particular, the hall’s Superior Electric Tri County is not the Superior Electric Great Lakes (SEGLC) name in Walbridge’s release.[11][3]

How can a subcontractor pursue work?

Walbridge’s subcontractor portal describes vendor prequalification for subcontractors, suppliers and design professionals.[4] It says the review considers experience, safety, bonding, insurance, licensing and financial resources.[4] Vendors must renew their profiles annually.[4] Walbridge advises firms to check its Bid Agenda and use the EPR link for a specific project, then contact the appropriate estimator.[4]

Prequalification puts a company into Walbridge’s evaluation process; it does not award work or establish that a Barn package is open.[4] Check the current Bid Agenda for a named project and ask its estimator about scope, deadlines and eligibility before preparing a proposal. We have not verified a Barn-specific bid entry. Related Digital’s careers page serves job applicants, not subcontractor bids.[2]

What do the dated union calls say?

November 16 advertised dispatch calls

Local 252’s November 16 call sheet advertises 48 journeyman inside wireman (JIW) positions at The Barn: six Motor City Electric splicers, 14 with Shaw, 10 on days and 10 on second shift with Superior Electric Tri County, five with Swan Electric and three with Triangle. RESA Power separately advertises five low-voltage and five medium-voltage test technicians. The sheet lists no VDV calls for November 16.[11]

The inside-call section was updated November 13 at 4:31 p.m. We checked it on November 15. Barn JIW calls require a Michigan electrical license or State of Michigan apprentice registration and a drug test current within 90 days. Motor City Electric’s splicer call also requires Ray Chem MV certification. JIW daybook sign-in is in person at the hall from 8 to 8:30 a.m., with dispatch at 8:30 a.m. The separate RESA calls require a drug test, prefer NETA experience and direct interested workers to leave a voicemail. Read the current call sheet and referral instructions before traveling.[11][12]

November 12 advertised dispatch calls

Local 252’s November 12 call sheet advertised 53 journeyman inside wireman (JIW) positions at The Barn: A.F. Smith, 10; Genco, one; Motor City Electric splicers, six; Shaw, 14; Swan Electric, five; Syenergy, four; Triangle, eight; and VEC, five. RESA Power separately advertised five low-voltage and five medium-voltage test technicians. The sheet listed no VDV calls for November 12.[11]

The inside-call section was updated November 11 at 4:22 p.m. The JIW notices required a Michigan electrical license or State of Michigan apprentice registration and a drug test current within 90 days. The splicer call also required Ray Chem MV certification. JIW daybook sign-in was 8 to 8:30 a.m. at the hall, followed by dispatch. The RESA notices directed interested workers to leave a voicemail and required a Michigan electrical license and drug test, with NETA experience preferred. Confirm current calls and referral instructions with the hall before traveling.[11]

November 11 advertised dispatch calls

Local 252’s November 11 call sheet advertised 50 journeyman inside wireman (JIW) positions at The Barn: A.F. Smith, 10; Motor City Electric splicers, six; Shaw, 14 on days and two on second shift; Swan Electric, five; Syenergy, five; and Triangle, eight. RESA Power separately advertised five low-voltage and five medium-voltage test technicians. The sheet listed no VDV calls for November 11.[11]

The inside-call section was updated November 10 at 4:28 p.m. The JIW notices required a Michigan electrical license or State of Michigan apprentice registration and a drug test current within 90 days. The splicer call also required Ray Chem MV certification. JIW daybook sign-in was 8 to 8:30 a.m. at the hall, followed by dispatch; the RESA notices directed interested workers to leave a voicemail and required a Michigan electrical license and drug test, with NETA experience preferred. These are dated advertisements, not remaining-vacancy counts. Check the current call sheet and confirm referral instructions before traveling.[11]

November 9 advertised dispatch calls

Local 252’s November 9 call sheet advertised 94 journeyman inside wireman (JIW) positions at The Barn, including six splicers. Separate listings advertised 10 RESA Power test-technician positions and two installer-technician positions. The inside-call section was last updated November 6 at 4:28 p.m.; the installer section was updated that day at 4:27 p.m. We checked both on November 7, ahead of the advertised November 9 dispatch. These advertisements do not establish how many positions remained unfilled after dispatch.[11]

The ten JIW calls were A.F. Smith, 10; Genco, one; Motor City Electric splicers, six; Shaw, 14; Superior Electric Tri County, 10 on days and 10 on second shift; Swan Electric, five; Syenergy, five doing HVAC controls; Triangle, eight; and VEC, 25 doing BMS and EPMS systems. The splicer call required Ray Chem MV certification. All Barn JIW calls required a Michigan electrical license or State of Michigan apprentice registration and a drug test current within 90 days.[11]

RESA Power advertised five low-voltage and five medium-voltage test technicians, with NETA experience preferred and a drug test required. Those calls appeared under the hall’s voicemail/contact instructions. Shaw Systems advertised two installer technicians; the call required a drug test current within 90 days.[11]

The November 9 JIW and installer notices required in-person daybook sign-in at the hall from 8 to 8:30 a.m., with dispatch beginning at 8:30 a.m. Those instructions describe the November 9 dispatch, not a current availability check. Read the current Local 252 call sheet and confirm instructions with the hall before traveling. Nonmembers are directed to the job line.[11]

November 6 dispatch observation: The earlier sheet advertised 88 JIW positions, 10 separate RESA test-technician positions and three installer-technician positions. Those figures describe the retained November 6 notice, not remaining vacancies or a net change in jobs.[11]

October 28 dispatch update: Local 252’s October 28 sheet advertises 115 journeyman inside wireman (JIW) positions at The Barn Data Center: six Motor City Electric splicers, 14 with Shaw, 70 with Superior Electric Tri County, eight with Triangle and 17 with VEC. Superior’s calls comprise 50 day-shift and 20 second-shift positions. The sheet also advertises 10 RESA Power test-technician positions and four VEC installer-technician positions at the data center. De Cal’s eight water-treatment and wastewater-treatment positions remain separate. These are dated dispatch advertisements, not confirmation that positions remain unfilled. Check the hall’s current instructions before traveling.[11]

October 26 dispatch update: Local 252’s call sheet, checked October 24, advertises 42 journeyman inside wireman (JIW) positions at The Barn Data Center and 10 RESA Power test-technician positions. The electrical calls name Motor City Electric, Shaw, Superior Electric Tri County, Triangle and VEC. De Cal separately lists eight JIWs for the Barn wastewater and water treatment plants. Those infrastructure calls are not included in the data-center total. Confirm the current referral instructions with the hall before traveling; these advertised calls are not a count of positions still unfilled.[11]

The October 21 call sheet listed 89 electrical craft positions and 10 test-technician positions explicitly assigned to The Barn.[11]

On October 21, Local 252’s page still displayed JIW work calls for October 21, 2026, with the inside-call section last updated October 20 at 4:26 p.m.[11] It named these Barn assignments:[11]

Employer on the hall page Barn call in the October 21 listing
Motor City Electric 6 journeyman inside wiremen (JIWs) and 6 JIW splicers; splicers require Ray Chem medium-voltage certification. Both calls say six 10-hour days.
Shaw 14 JIWs, six 10-hour days.
Superior Electric Tri County 33 JIWs on a day shift and 16 on a second shift, each listed as six 10-hour days.
Triangle 8 JIWs, seven 10-hour days.
VEC 6 JIWs for building and electrical power management systems, listed as five 10-hour days and one 8-hour day.
RESA Power 5 low-voltage and 5 medium-voltage test technicians; NETA experience preferred.

These are advertised calls, not a count of people hired, unfilled positions now, or separate net new jobs.[11] For the Barn JIW calls, the page requires a Michigan electrical license or Michigan apprentice registration and a drug test current within 90 days.[11] To seek a listed call, applicants sign the in-person day book from 8 to 8:30 a.m.; dispatch starts at 8:30 a.m.[11][12] The referral rules separately give 8:30 a.m. to 12:30 p.m. or 1:30 to 3 p.m. for an original in-person book registration. Registering on the book is not the same as signing in for that day’s calls.[12] The RESA technician calls instead appear under instructions to leave a voicemail or contact the hall.[11] Read the current Local 252 work calls and its referral rules before traveling or calling.[11][12] Nonmembers are directed to the job line.[11]

An entry path for a new electrician is the Ann Arbor Electrical JATC application process, which describes in-person applications by appointment on the third Monday of each month, eligibility requirements and an aptitude test.[15] Apprenticeship admission is separate from a Barn dispatch.[15][11]

Employer job leads beyond dispatch

Related Digital’s Construction PM/SPM, Data Centers, Saline listing describes a full-time Saline role covering budget, scheduling, permitting, contractor selection, construction and commissioning.[13] It lists 10 or more years of data-center or mission-critical construction experience and an anticipated base range of $175,000 to $225,000.[13] The description names Saline and Related Digital, but does not explicitly name The Barn. Confirm the campus assignment with the employer.[13]

Walbridge’s Construction Scheduler listing, ID 2026-2443 shows a Saline work location and asks for five or more years of scheduling experience, with substantial travel.[14] It likewise does not name The Barn and says the candidate may be based elsewhere in the United States.[14] Check the employer’s current listing for availability and site assignment before applying.[14]

Jobs forecast versus people on site

OpenAI forecast more than 2,500 union construction jobs and 450 permanent onsite jobs.[1] Those are projected job totals across different types and periods, not current vacancies.[1] Related Digital reported more than 700 tradespeople on site on June 1, then more than 1,800 building the project and one million craft hours logged in its August 27 announcement.[7][10] Those dated observations are not a current headcount and should not be added to the forecast or to the hall calls.[1][10][11]

The labor agreement covers 14 signatory affiliated trades under the National Maintenance Agreement.[7] The electrical call sheet is one window into that workforce, not a directory of every craft’s hiring or apprenticeship route.[7][11]

Permits and power: what approval means here

The township’s January FAQ says the consent judgment governs site development, while county and state agencies retain their permitting roles. Its advisory notes say foundation permits for the Operations and Warehouse buildings had been issued by April 29. They do not establish a complete permit inventory for all three data halls. The township FAQ reports an EGLE permit to install generators and a pump; advisory notes also report wetlands permits.[9][5]

The project website says Related Digital applied for a treated domestic wastewater discharge permit, MI0060445.[2] EGLE scheduled a virtual public hearing for October 21 on the proposed new-use discharge permit for RD Michigan Property Owner I LLC and its Related Digital wastewater treatment plant.[16] The MiEnviro notice labels MI0060445 v1.0 a draft permit and lists a public notice period ending October 23.[17] This hearing and draft notice do not verify final issuance.[16][17]

The MPSC conditionally approved DTE Electric’s special power contracts in December 2025 for a 1,383 MW load contracted with Green Chile Ventures, an Oracle subsidiary. In March 2026, it approved the first 332 MW of DTE battery projects tied to the 1,383 MW storage arrangement. Contract and storage approvals do not show that batteries have been built or that the data halls are energized. The MPSC expressly says it does not issue construction permits or decide water use. Township notes on June 10 said substation equipment delivery would be delayed, but that dated note is not a current schedule update.[6][8][5]

Frequently asked questions

Is The Barn still hiring construction workers?

Local 252’s November 16 call sheet advertises 48 journeyman inside wireman positions at The Barn and 10 separate RESA Power test-technician positions. We checked the sheet on November 15. Read the hall’s current calls and referral instructions before traveling, because advertised positions can be filled or changed.[11][12]

Can my firm bid on the project through Walbridge?

Walbridge offers company-wide prequalification and tells firms to monitor its Bid Agenda. We have not verified an open Barn bid. Check the current agenda and project EPR entry before preparing a proposal.[4]

Is the project complete because a building was nearly finished in June?

No. Related Digital described the first of three buildings as nearing completion on June 1, while the project website projected construction through 2027 and phased delivery. Neither statement verifies completion or power-up of a particular phase.[7][2]

Does the power approval cover building and water permits?

No. The MPSC decision concerns utility service terms.[6] The township describes separate county and state construction and environmental reviews.[9] EGLE’s October 21 hearing concerns a proposed wastewater discharge permit, and MiEnviro labels the permit draft, not finally issued.[16][17]

Are the advertised 2,500 construction jobs available right now?

The 2,500 figure is a forecast for construction employment, not current vacancies. The August 27 release reported more than 1,800 tradespeople then building the campus; the hall sheets describe separate dated dispatch advertisements, including the November 16 calls above.[1][10][11]

More Echelon data-center construction reports

Sources

  1. Building the infrastructure for the Intelligence Age in Michigan
  2. The Barn Data Center | Related Digital – Saline, MI
  3. Walbridge Is Building the Largest Project in Its 110-Year History – Right Here in Michigan – Walbridge
  4. Subcontractor Portal – Walbridge
  5. Advisory Committee Meetings
  6. MPSC approves DTE Electric energy contracts for data center with conditions to strengthen protections for other customers
  7. Related Digital, Blackstone, Oracle, OpenAI, Walbridge and Governor Whitmer Celebrate Construction of Stargate Campus in Saline Township
  8. MPSC goes big on batteries, approving six energy storage contracts totaling 1,332 megawatts
  9. Saline Township Data Center Project Information and Frequently Asked Questions (January 28, 2026)
  10. Related Digital, Oracle, Walbridge, Blackstone and labor leaders celebrate one million (union) work hours at The Barn in Saline Township
  11. IBEW LOCAL 252 Work Calls
  12. IBEW Local 252 Daybook Referral Rules (effective September 11, 2026)
  13. Construction PM/SPM – Data Centers (Saline, MI) in Saline, Michigan | Related
  14. Construction Scheduler in Saline, Michigan | Careers at Saline, MI
  15. HOW TO APPLY | Aaejatc
  16. EGLE public hearing for proposed new-use NPDES permit MI0060445
  17. MiEnviro Public Hearing – Draft Permit, MI0060445 v1.0
  18. Related Digital announces financing for $16 billion Saline Township campus
  19. ENR: Oracle Michigan campus financing and reported contractor assignments

Echelon Trades Jobs

Hiring or looking for work in the trades?

Employers can submit an opening for review. Tradespeople can tell us what work they want. Both are free, and worker profiles stay private.

Post a free job Tell us what work you want

Visit Echelon Trades Jobs
